AVALANCHE MITIGATION FOR MSP 11 NEAR ROHTANG TUNNEL

Viti
2021
Vendndodhja
APPROACH ROAD TO ROHTANG TUNNEL SOUTH PORTAL - HIMACHAL PRADESH - India
Klienti
Border Roads Organisation (BRO) - ROHTANG
Projektuesi
MACCAFERRI ENVIRONEMNTAL SOLUTIONS PVT. LTD.

Sfida

Atal Tunnel (formerly Rohtang Tunnel) is a strategic all-weather highway tunnel and one of the longest road tunnels in India. Being built on extremely challenging Himalayan terrain, the overall alignment and its vicinity is prone to many natural hazards such as cloud bursts, earthquakes, landslides, rockfalls, avalanches etc. Many locations along the approach road to the Manali south portal (MSP) have been susceptible to snow avalanche events, which have been causing considerable harm to people, infrastructure and machinery. Some critical locations, such as MSP 11 (at km 10.5) are identified near the MSP where avalanche paths are identified with starting (formation) zones located at very high altitudes of approx. 3100m above, where avalanche control structures are required to be provided. The reported snow thickness at MSP 11 is approx.4m.

Zgjidhja

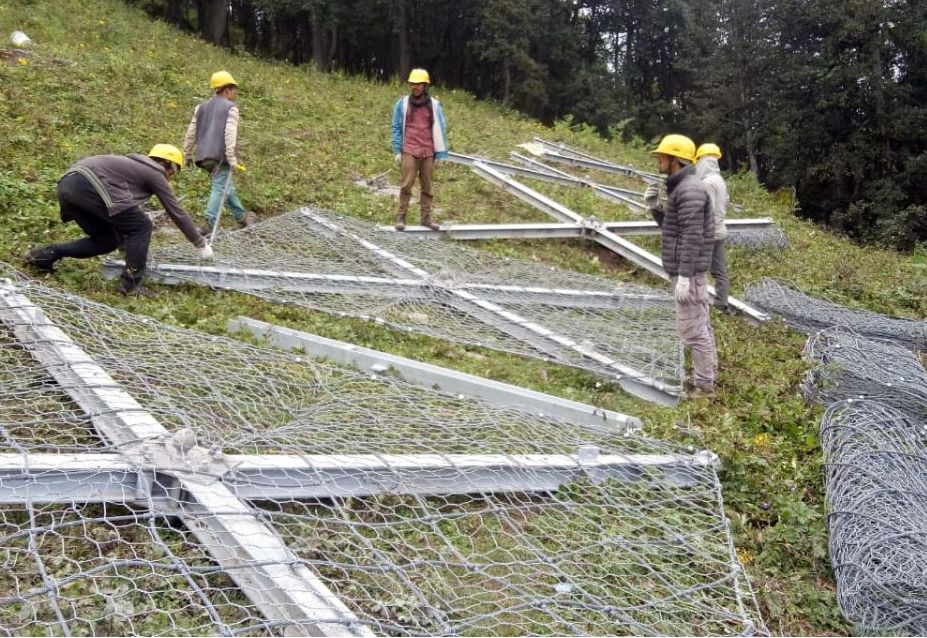

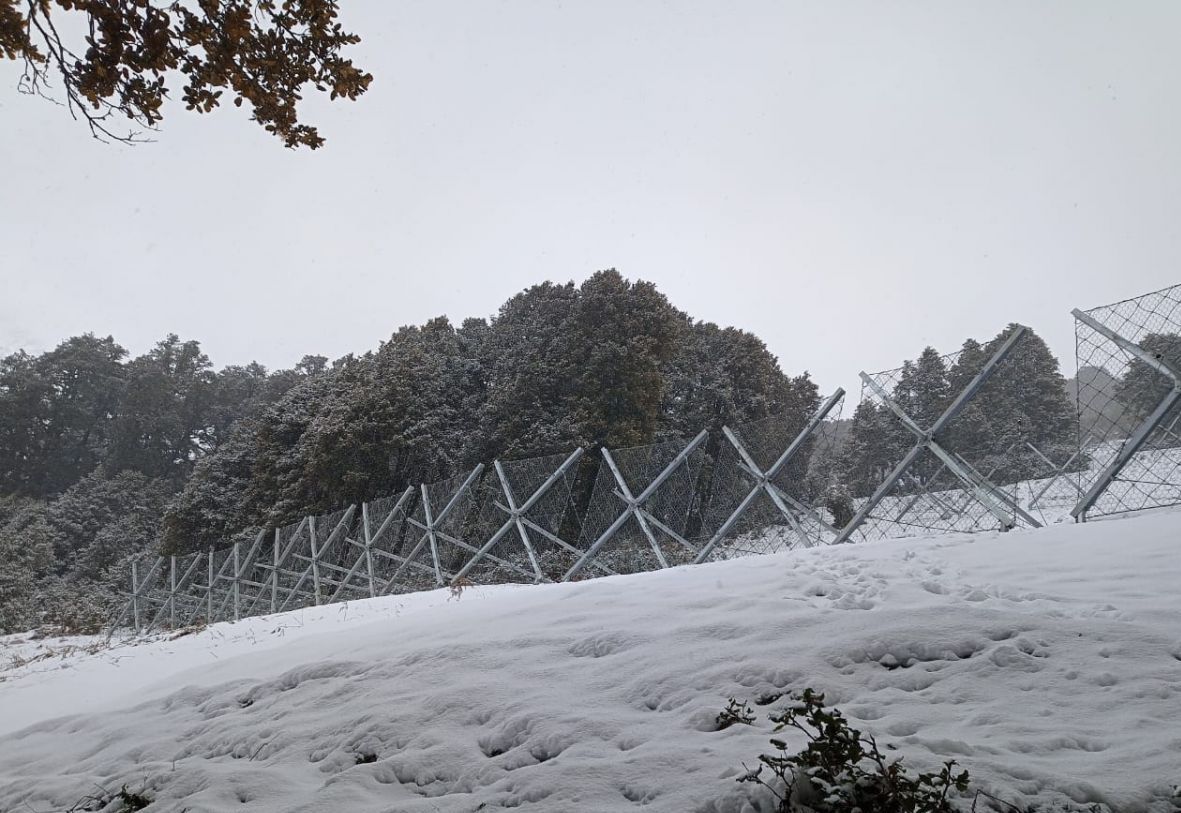

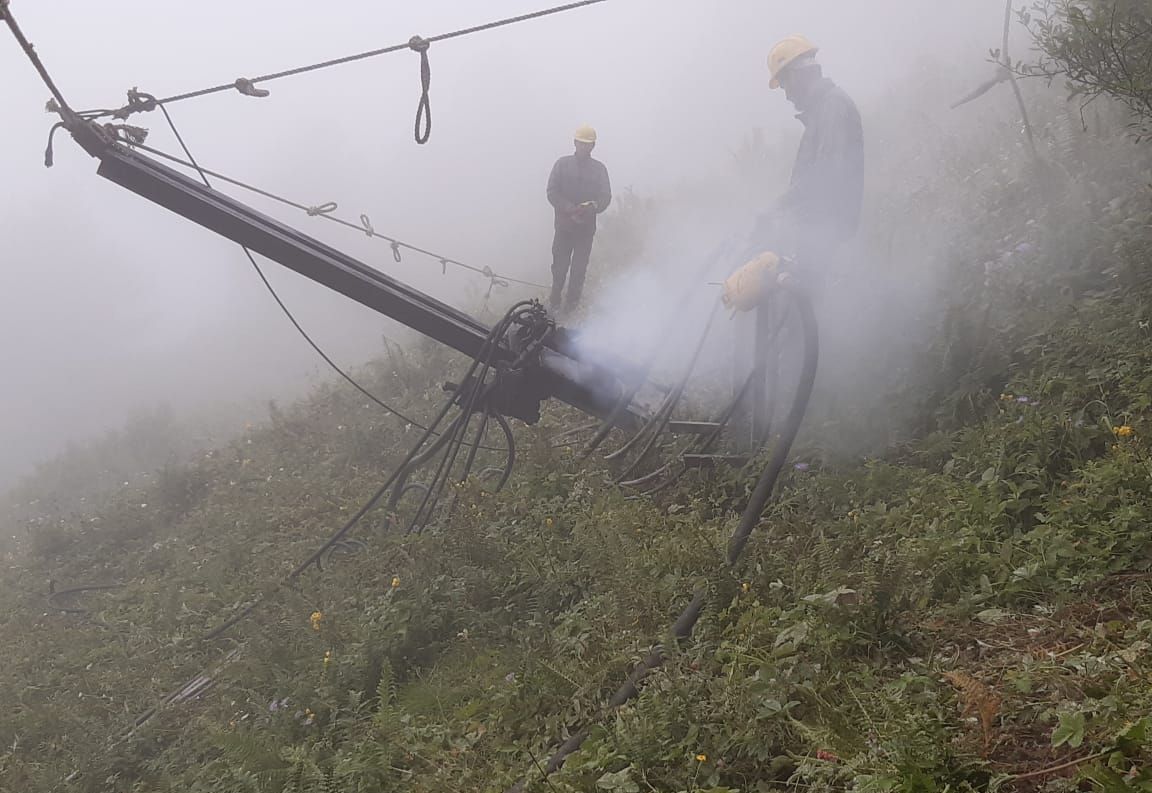

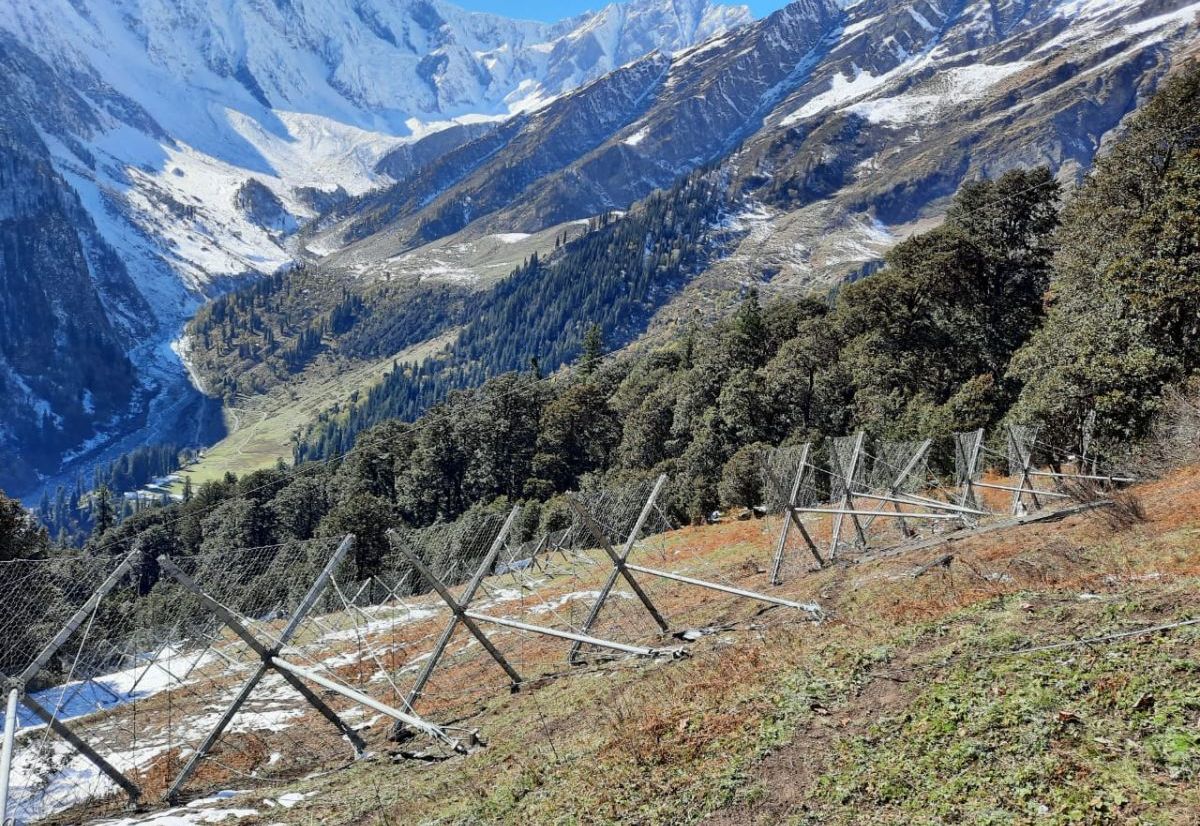

Based on the prevailing difficult site conditions and short construction window available, flexible snow barriers comprising of snow umbrella (Snow ErdoX) units are selected for MSP 11. Snow ErdoX units are advanced avalanche protection system, which are self stable and has metallic structure with pyramid shape, lesser weight, easy to transport and quick to install. As the snow accumulates on the slope, these innovative control measures retain the accumulated snow pack, thus preventing the initiation of an avalanche. Based on functional design, 10 lines of Snow ErdoX barriers (120 no.s (external reinforced units and internal unreinforced units) are constructed to constitute a total stretch length of 469m. The design of Snow ErdoX is based on Swiss technical guideline(2007). The lines are spanning above and below the highway based on the min. spacing calculated and overall identified formation area with individual Snow ErdoX units installed at distance of a 50 cm from each other(to allow the passage between the structures, which is prevented by traditional barriers). The end units on each of the barrier lines shall be of reinforced type. The foundation system of Snow ErdoX units are of anchors -SDA-32mm and pull out tests are performed to verify the bond strength considerations.

Shkarkoni Histori Suksesi

AVALANCHE MITIGATION FOR MSP 11 NEAR ROHTANG TUNNEL

Shkarko
AVALANCHE MITIGATION FOR MSP 11 NEAR ROHTANG TUNNEL

Lidhuni me ne

Nëse jeni dakord me Politikën e Privatësisë të kompanisë dhe keni kuptuar përmbajtjen e saj, Kontrolluesi i të Dhënave ju pyet nëse jepni pëlqimin për përpunimin e të dhënave në mënyrën e parashikuar nga politika e privatësisë e kompanisë, për dërgimin e komunikimeve promovuese për shërbimet/aktivitetet e ofruara nga Kontrolluesi i të Dhënave. *

Për më tepër, Kontrolluesi i të Dhënave ju pyet nëse jepni pëlqimin për komunikimin e të dhënave tuaja personale te Filialet e Maccaferri, dhe transferimin e mundshëm jashtë BE-së që mund të rezultojë, për qëllimet e tyre, përfshirë ato të natyrës promovuese (dërgimi i komunikimeve të marketingut) *
