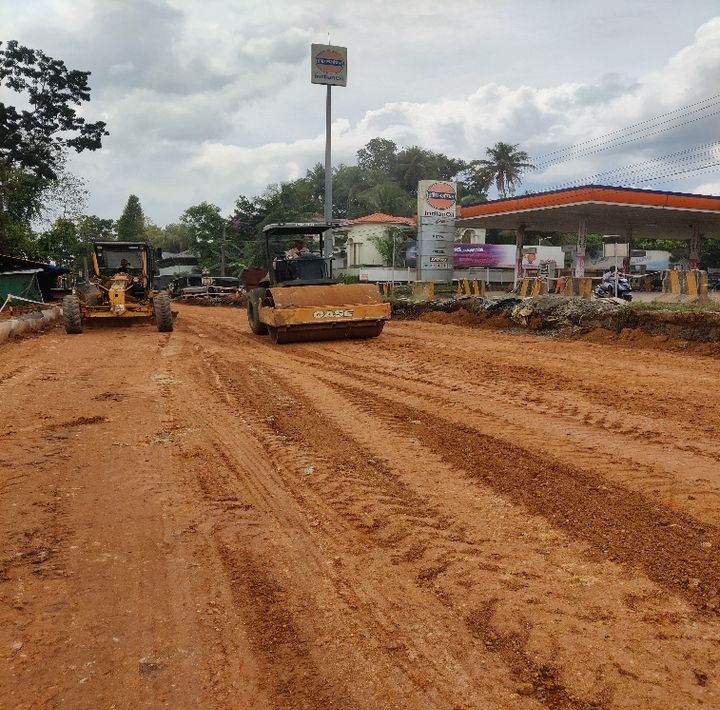

Challenge

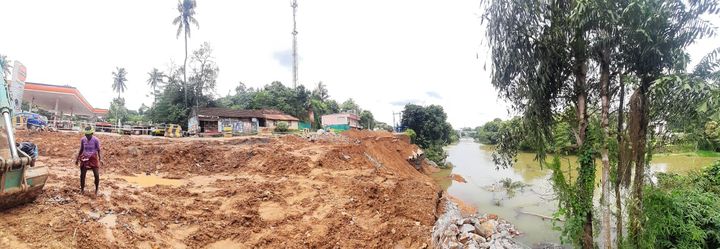

Upgradation of PUNALUR TO PONKUNNAM ROAD (SH 8) ‐ PACKAGE 8A: 0+000(PUNALUR) to 29+840(KONNI) work under KSTP carried out by CVCC – RDS joint venture. In that, newly constructed Gabion retention wall of around 9m high between Ch.0+600 to Ch.0+670 has failed for a length of 70 m and went entirely into the Kallada river due to heavy flood in 1st week of July 2022. Backfilling was completed without proper compaction and filling with lateritic soil.
Restoration of failed structure has to be carried out to achieve the road width and to protect the bank slope from scouring against the river flow.
Solution

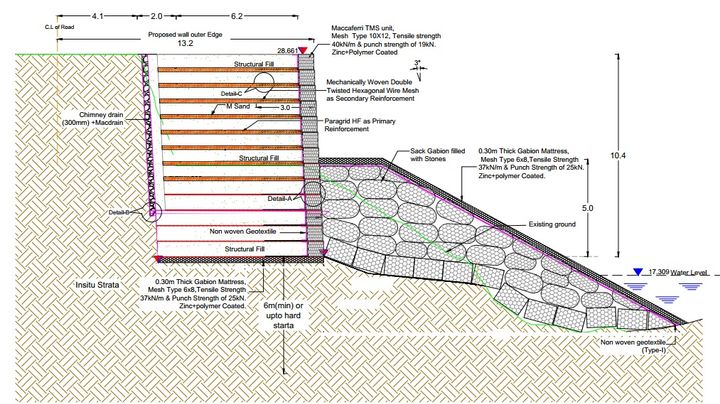

For regain the existing road width, a Reinforced Soil Wall with free draining Gabion fascia has been proposed for a stretch length of 70 m from Ch. 0+600 to 0+670 as per BS 8006-1-2016. Reinforced soil wall is properly designed for the anticipated traffic and seismic loads for retention purpose. Reinforced soil system is advantageous in terms of better uniform pressure distribution at the base of the wall. Differential settlement will be addressed effectively as the system is flexible and monolithic.

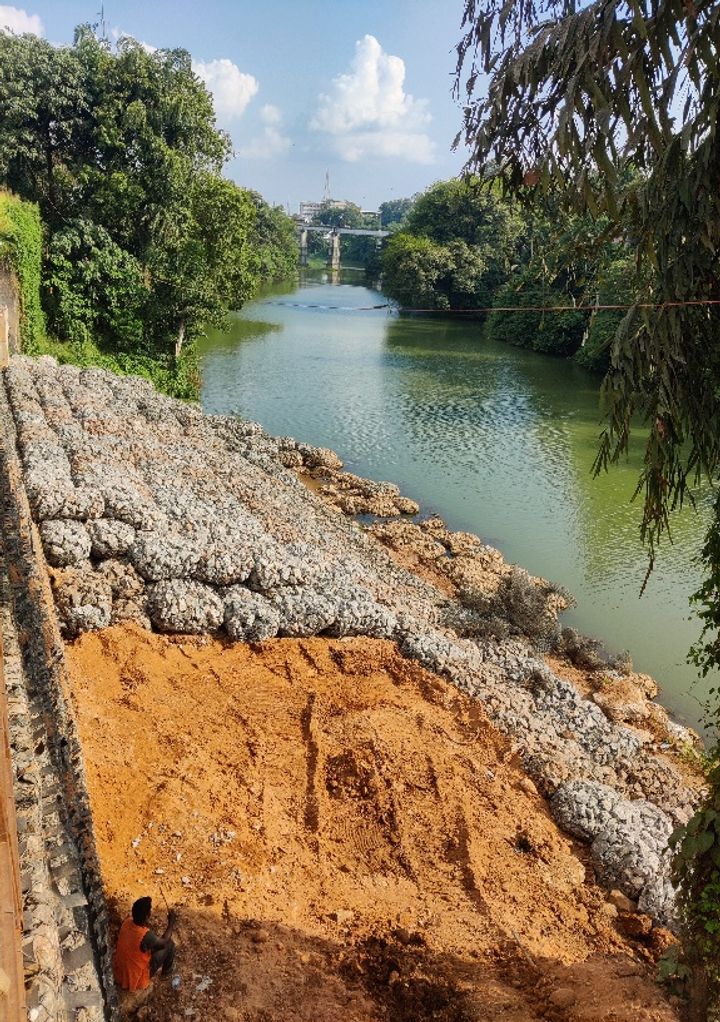

For the toe protection a counter berm of sufficient height has been developed using the Sack Gabions & Gabion mattress at the toe of wall.
Download
the Success Story
Download
Our products for
this Success Story
Get in touch with us
[contactForm_txtSuccessSubmit]
